Could be Cargo scheduler improved?
August 28, 2026
I have recently added a new scheduler to HyperQueue. It is based on MILP, and the implementation uses HiGHS, which quickly became a rather large crate in terms of compilation time. Since I have been hanging around schedulers for the last ~10 years, I started wondering how Cargo actually schedules its work, and whether it could be done better.
Note 1: I am not familiar with Cargo's internals. The whole analysis here is based on observing its behavior from the outside, not on digging into its source code.
Note 2: For all experiments, rustc 1.97.1 is used.
Benchmark & graphs
First, let's set up a benchmark. I picked 17 well-known Rust projects, plus two projects that I maintain myself: HyperQueue and FairyFlow.
Their build times vary quite a lot, so it is not a bad starting point. Note that, for the sake of simplicity, we always consider a plain debug build (cargo build); cargo check and release builds are not considered here.
To experiment with scheduling, we first need to record the dependency graph between the individual build tasks (i.e. the invocations of rustc and friends). We need this graph so we can replay the same build under a different schedule.
Cargo has a build-timing feature (cargo build --timings), but its output does not give us enough information to reconstruct the dependency graph. Tracing the syscalls that Cargo and its children make gets us there instead; that is enough to see which files each rustc process reads and writes, and in what order, and from that we can derive both the dependencies and precise per-task start/end times.
There is one tricky detail here: to start compiling a crate, we don't need its dependencies to be fully compiled; we just need their metadata (.rmeta). This is also visible through the traced syscalls (the .rmeta file gets created before the rest of the compilation finishes). So in our graph, running rustc on a single crate is actually represented as two nodes: "frontend", which produces the metadata, and "rest", which finishes the compilation (codegen and linking). Dependent crates only wait for "frontend" to complete. There is also a "forced continuation": once "frontend" is done, "rest" has to run right after it, on the same worker, because it's the same OS process just continuing to run; the scheduler has no say in it.

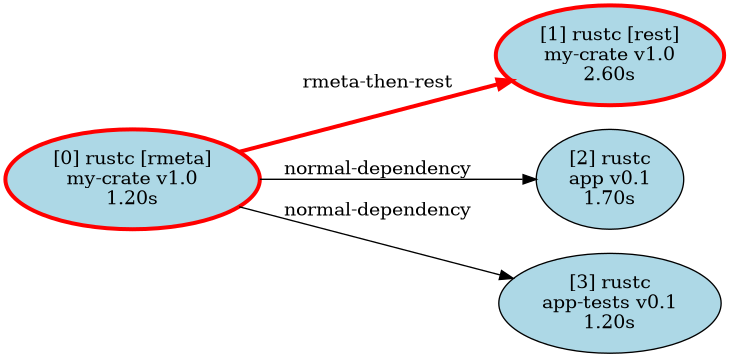

Here is a tiny made-up example to illustrate this. Crate app and app-tests both depend on my-crate. They only need to wait for my-crate's frontend, while my-crate's own "rest" node is forced to follow right after its own frontend:

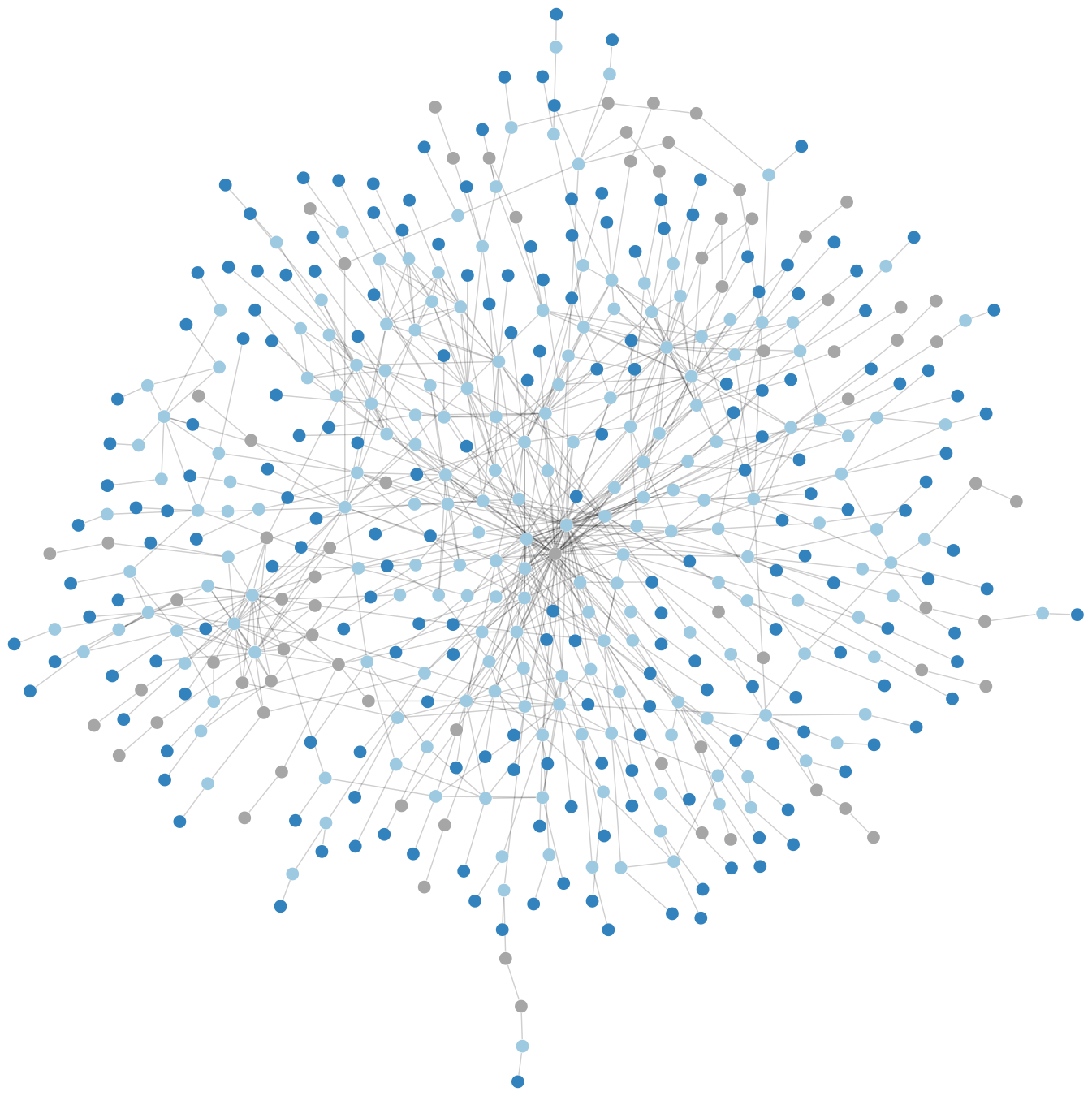

To give a sense of scale, here is the graph for HyperQueue: 471 nodes and 821 edges.
In the rest of this post I will only use parallelism levels n=16 and n=4. 16 is my laptop's core count, and 4 stands in for a more constrained environment (say, a small CI runner). Note that scheduling is trivial at both extremes: with a single CPU there's nothing to decide, we just have to run everything and the order doesn't matter (ignoring caches, for simplicity); and with an unlimited number of CPUs, we can just run everything that is ready right away. The interesting range is somewhere in between.
Schedulers

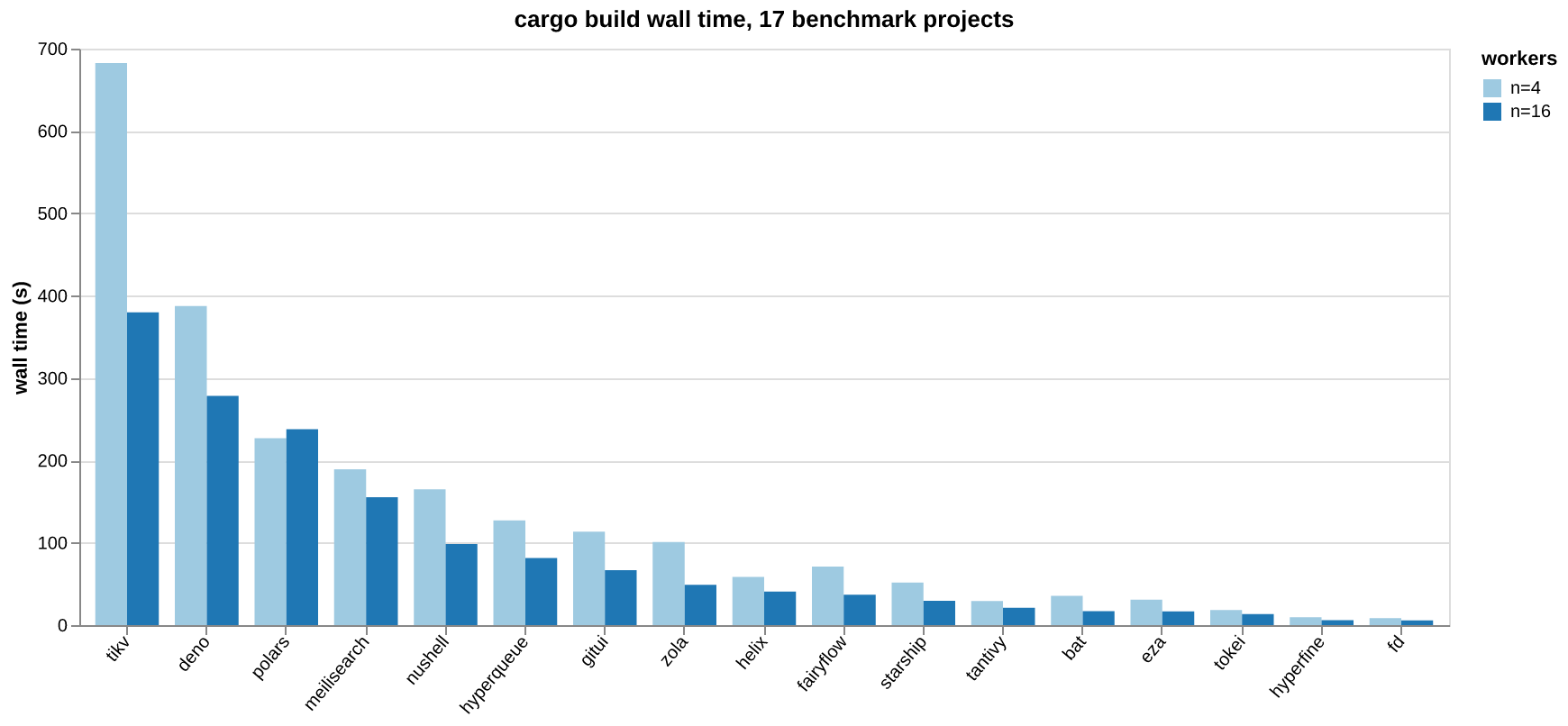

Replay of Cargo's own scheduling decisions (our baseline) is denoted as "cargo" in the following charts. The measured wall time of a real build is usually a bit larger than what we get by replaying its recorded tasks, because of some extra overhead that our simulation doesn't model. But since we compare everything against this same "cargo" replay, and the scheduling logic is the only thing that differs between our schedulers, it is a fair baseline.
My first instinct was to try a b-level scheduler. It turned out to be quite promising, and stayed the best simple scheduler I tried, so let me describe it.
For every task, we compute its "b-level" (bottom level): the length of the longest chain of tasks that still needs to run after it, following the dependency graph, all the way to the end of the build. In other words:
(with blevel(t) = duration(t) for a task with no children). Whenever a worker becomes free, the scheduler picks the ready task with the highest b-level. The idea is simple: prioritize tasks that are on, or close to, the critical path, since delaying them delays everything that depends on them.
I also tried a bunch of other approaches, just to see if something would beat it: fan-out (prioritize tasks that unblock the most other tasks), shortest/longest-job-first, a scheduler that prioritizes tasks close to producing an .rmeta ("rmeta-gate"), a couple of b-level variants combined with fan-out ("cp-misf" and a version with a small tie-breaking epsilon), and local search (simulated annealing) starting from a random or from the b-level schedule, using several kinds of moves (random jitter, swapping two tasks, swapping nearby tasks) with random restarts. Generally, all of these ended up being worse than plain b-level, or at best matched it.
Results

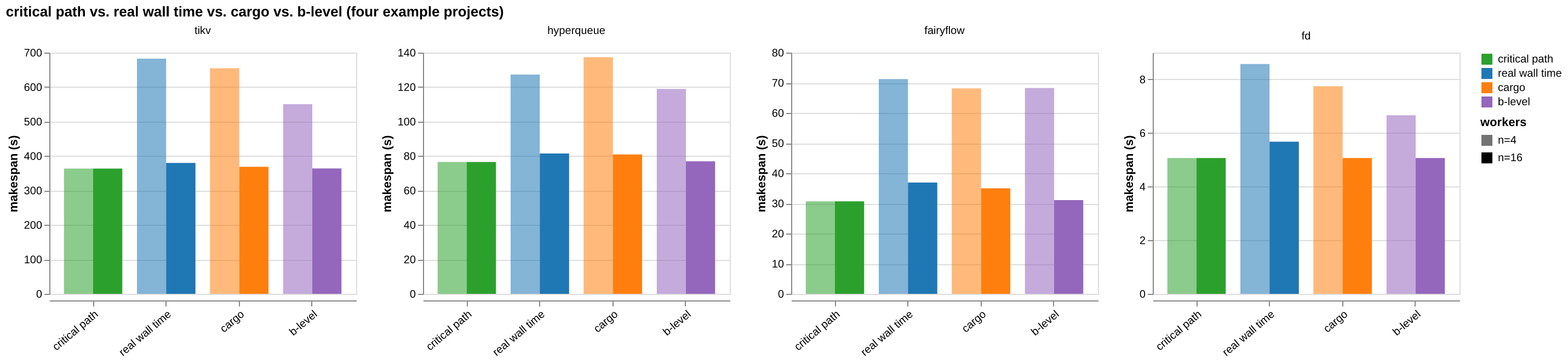

The chart above shows, for a few representative projects, the makespan of the "critical path" (the length of the longest dependency chain; the best possible time achievable with an unlimited number of CPUs), the real measured wall time, the replayed "cargo" schedule, and b-level, at both n=4 and n=16.
You may notice that for HyperQueue at n=4, the real wall time is slightly smaller than the replayed "cargo" makespan, even though the replay uses cargo's own recorded order and durations. I looked into this: it happens at n=4 for 3 out of 17 projects (HyperQueue, tantivy, zola), but for none at n=16. To be honest, I do not know why.
Let us make it short: b-level is the winner. Not surprisingly, it helps more when n=4, when resources are more constrained. Across the 17 projects, at n=4 b-level beats cargo's own schedule in 15 out of 17 cases, saving a median of about 8% of the wall time (up to 16% on the best case). At n=16, it still wins in 14 out of 17 cases, though the gain shrinks to a median of about 2% (up to 15%); which makes sense, since there is simply less room for a bad decision to matter when almost everything can run at once anyway.
But how far are we from the actual optimum? Unfortunately, this scheduling problem is NP-hard, so we cannot just compute the true optimum for graphs with hundreds or thousands of nodes. Instead, let's build a "pseudo-optimum": the best result we have seen for a given project and CPU count, out of all the schedulers we tried, including local search with random restarts run for 10 000 iterations for each of the randomized approaches. It's not guaranteed to be the true optimum, but it is probably a very close to it.

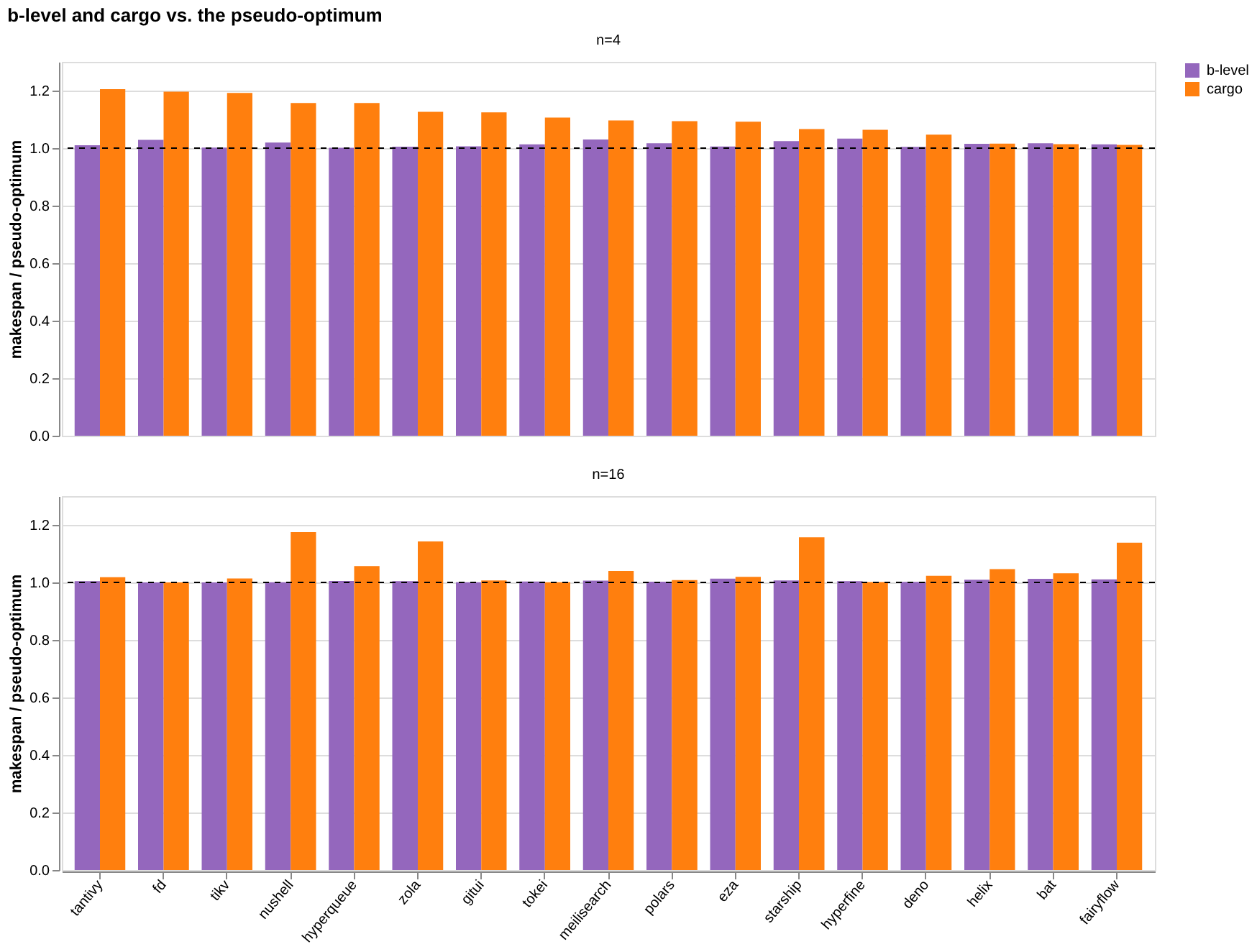

The chart shows b-level and cargo, both divided by the pseudo-optimum, so 1.0 means "as good as the best schedule we found". At n=4, b-level lands at a median of about 1.3% above the pseudo-optimum (worst case 3.3%), while cargo is at a median of about 9.6% above it (worst case 20%). At n=16, b-level is a median of 0.4% above (worst case 1.3%), cargo a median of 2.3% above (worst case as high as 17.5%). So a simple greedy heuristic that just picks the highest b-level task turns out to already be very close to what much more expensive search can find.
Is it really feasible?
The whole approach has one obvious problem: it assumes we know each task's execution time in advance. In reality, we don't have exact numbers; at best we have some rough, historical estimate.
So, how sensitive is b-level to wrong estimates of durations? To test that, I gave the scheduler a noisy "assumed" duration for every task instead of the real one:

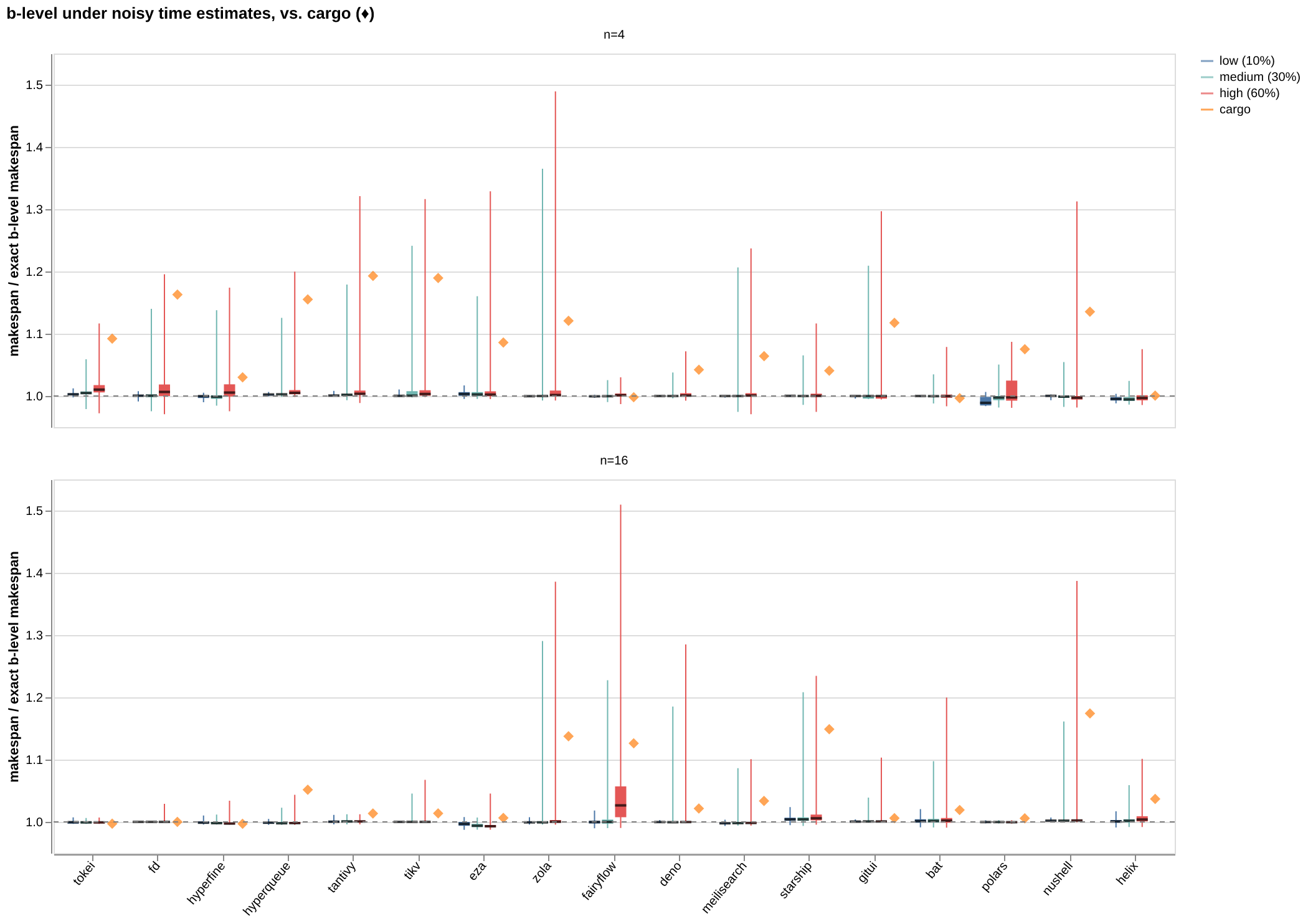

The scheduler makes all of its decisions based on assumed, but the simulation still advances time using the task's real, recorded duration; exactly like a real build would behave if our time estimates were off. I tried three noise levels: σ=10% (a reasonably calibrated estimate), σ=30% (fairly rough), and σ=60% (not much better than a guess), each repeated 10 000 times per project.
To make this concrete, here are three actual draws from the noise generator, for a short 2s task and a long 20s task:
| real duration | assumed, σ=10% | assumed, σ=30% | assumed, σ=60% |
|---|---|---|---|
| 2.0 s | 2.19, 2.26, 2.47 s | 2.57, 2.77, 3.40 s | 3.13, 3.55, 4.81 s |
| 20.0 s | 17.21, 22.90, 18.67 s | 11.62, 28.70, 16.02 s | 3.24, 37.39, 12.05 s |
Notice that in the first draw at σ=60%, the 20s task's assumed duration (3.24s) ends up smaller than the 2s task's (3.13s); the scheduler would think the long task is the shorter one. That's what "not much better than a guess" looks like in practice — and also why the three draws swing so wildly (17s, 23s, or 37s, all for the same 20s task) once σ gets that large.

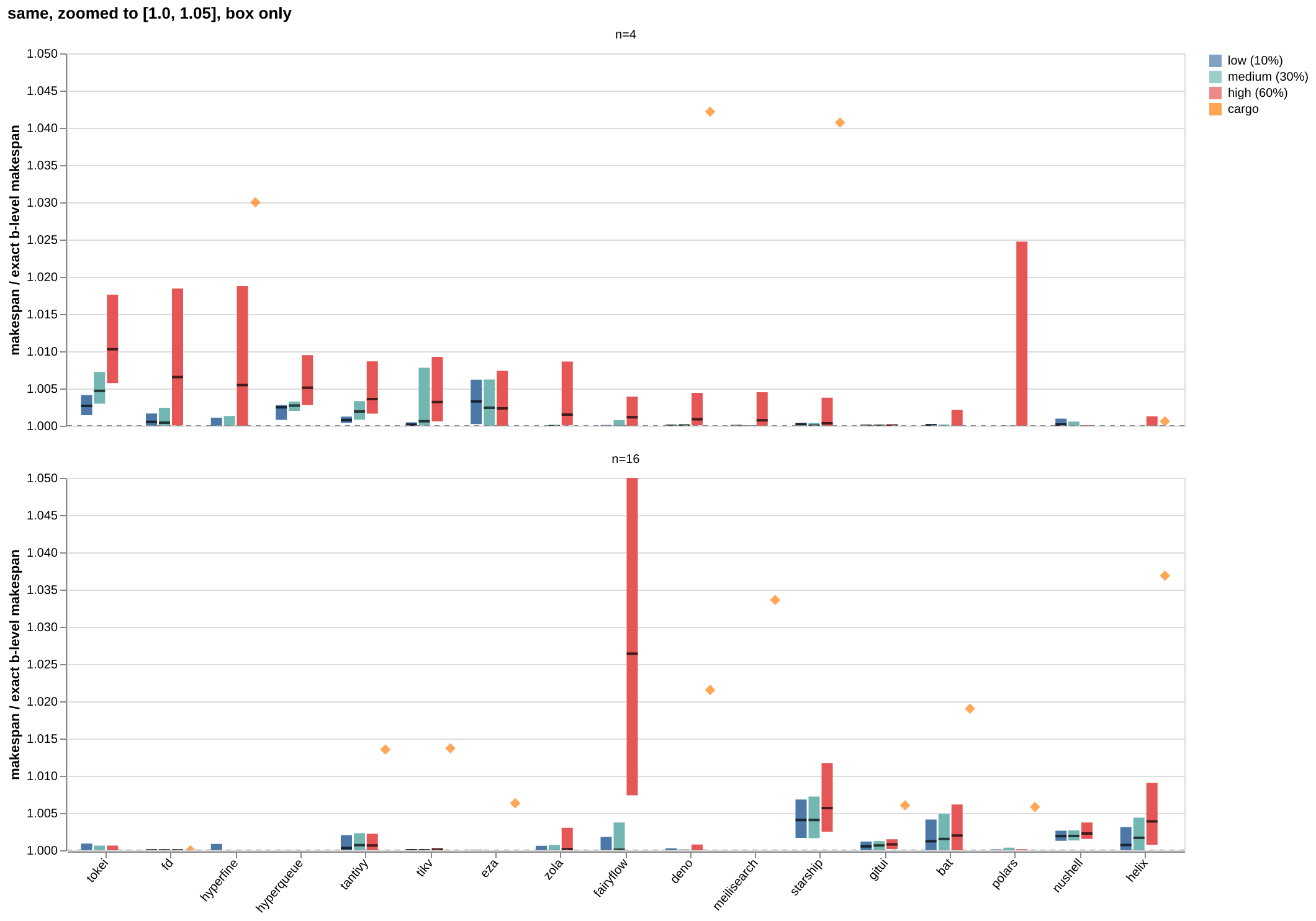

For better clarity, here is the same data again, zoomed in on the box around 1.0, without the whiskers (the extreme outliers make the boxes hard to see otherwise):
The orange diamond marks the "cargo" baseline; the y-axis itself is already a ratio to plain b-level with exact, noise-free durations, so that one sits right at 1.0 by definition. The result is reassuring: b-level with noisy estimates stays very close to the noise-free b-level makespan across all three noise levels; the median stays within a fraction of a percent, even at σ=60%. Some unlucky individual runs do get noticeably worse (occasionally by 30–50%), but that's the tail, not the typical case; the median of the noisy runs still comfortably beats the "cargo" baseline.
This is good news, because it means we don't actually need to know execution times precisely. We don't even need real time units; a rough, relative estimate is enough. Something as simple as "this crate usually compiles about twice as long as that one", perhaps derived from a small local history database of past builds, should already be good enough to get most of the benefit of b-level scheduling. Or maybe a global database for bootstrap data in the local database?
